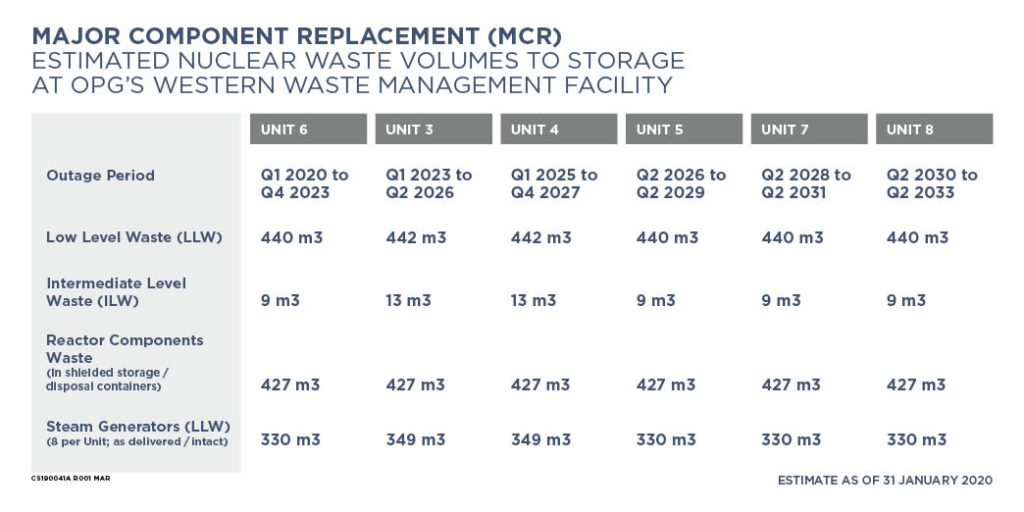

• Estimated Nuclear Waste Storage during MCR

    The above chart is the estimated nuclear waste volumes to storage as part of Bruce Power’s Major Component Replacement Project, which began in Unit 6 on January 17, 2020.

    To learn more, visit www.46moleng.site/life-extension-program-mcr-project.

    Stay in touch

    Sign up for our monthly eNewsletter

    * indicates required
    茄子在线资源在线观看视频
